Sorry, but are we in line with other cities is the wrong question. Stop the UEP debacle,start at zero cost to the consumer, then figure out how the rest of country funds federally mandated clean drinking water and sewer hook-ups.
The Utilities Extension Project (UEP) extends city water, sewer, and irrigation services to previously unserved areas of Cape Coral (primarily northwest and north sections relying on private wells and septic systems). While intended to support growth, improve water quality, and protect the environment, the project has generated significant resident backlash due to high mandatory costs and prolonged construction disruptions.
1. Punitive Financial Assessments and Hook-Up Costs
- Special Assessments: Property owners face substantial one-time charges (often $35,000–$40,000+ per equivalent residential parcel, depending on the phase like North 1 West/East or North 3; varies by lot size/frontage and includes water, sewer, and irrigation components). Northwest Cape Coral assessments are projected at $60,000 per home, $100,000+ if paid over time. These are levied via property taxes, with financing options over 20–30 years at interest rates that can push annual payments to $3,000–$4,000+. Prepayment avoids some interest but requires large upfront cash.
- Additional Hook-Up Expenses: Beyond assessments, owners pay $3,000–$6,000+ for plumber connections, septic tank abandonment, permits, meters, and deposits. Mandatory connection deadlines (often 180 days after Notice of Availability) add urgency and risk of penalties.
- Impacts on Residents:
- Financial Strain: Hits fixed-income retirees, working families, and those on modest homes hardest. Some describe it as “catastrophic,” leading to fears of losing homes, higher tax bills exceeding current city taxes, or deferred maintenance/sales.
- Perceived Unfairness: Residents argue they already pay property taxes for infrastructure, question cost allocation (“growth should pay for growth”), and note limited grants or relief (e.g., $4,000 income-qualified connection grants help few). Larger or multi-lot properties face multiplied burdens.
- Market Effects: Realtors have cautioned against selling during assessment periods due to “sticker shock”; potential impacts on property values, resale, and buyer hesitation.
2. Construction Disruptions
- Duration and Scale: Multi-year phased construction (e.g., North 1 phases ongoing/completing 2026+, North 3 into 2028) with daily work (up to 12 hours, 5–6 days/week, possible weekends), road closures, detours, and heavy equipment.
- Daily Impacts: Restricted driveway access, torn-up streets/sidewalks/curbs, dust/noise, interrupted garbage/mail service, traffic delays, and safety concerns. Businesses and daily commutes suffer; some residents report prolonged “headaches” and frustration over vague timelines.
- Broader Effects: Reduced quality of life, potential property damage (requiring documentation for claims), and temporary loss of access/amenities in affected neighborhoods.
Overall Resident Sentiment and Risks
Many view the mandates as overreach—preferring existing well/septic systems—and resent bearing costs for city growth. Public meetings show opposition, with complaints of inadequate communication, insufficient relief, and disproportionate burden on current homeowners vs. new development.
Longer-Term Risks: Increased utility rates post-connection, potential for further assessments in later phases (North 3/6+), and secondary effects like slowed real estate activity or homeowner financial distress. While grants and financing mitigate some costs, negative perceptions dominate local opinions.
Overview of the Utilities Extension Project (UEP)
The Utilities Extension Project (UEP) is a multi-billion-dollar initiative by the City of Cape Coral to extend city-managed potable water, sanitary sewer, reclaimed irrigation water, fire hydrants, lift stations, master pump stations, stormwater improvements, and new roads to northern areas of the city that currently rely on private wells and septic systems. This addresses aquifer depletion, environmental risks from septic failures, and supports growth while promoting water reuse (treated wastewater for irrigation, supplemented by canal water). The project stems from the 2022 Comprehensive Utilities Master Plan Update and is funded primarily through special assessments on properties (billed as non-ad valorem on tax bills), water fees, and state grants (e.g., $6.5 million awarded in December 2025 for North 1 East reclaimed water).

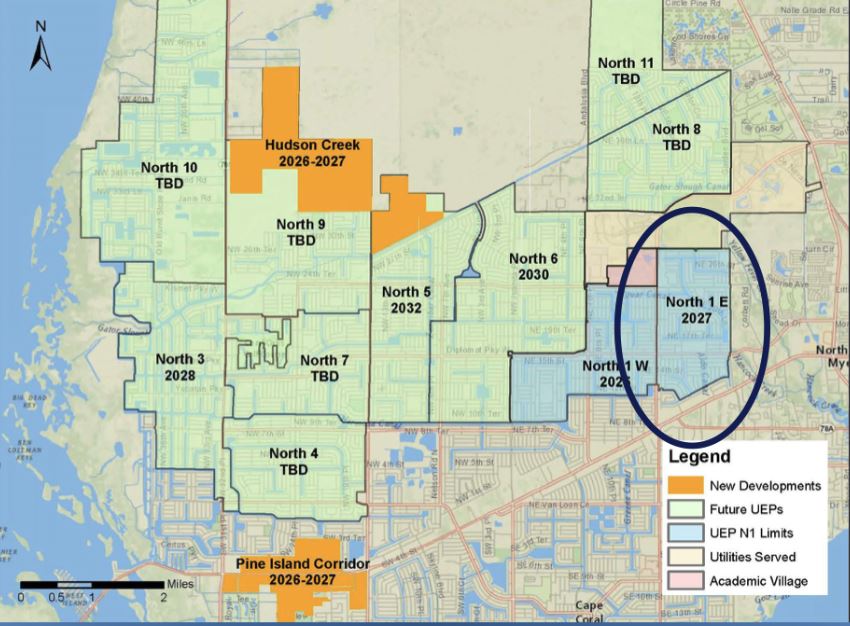

Phases are sequenced geographically, starting in the northeast quadrant and moving westward and northward. Construction is divided into contract areas (e.g., North 1 West has six contracts; North 1 East has five). Residents receive “Notice of Availability” letters post-construction, requiring connection within 180 days for developed properties (or before occupancy for undeveloped ones). Assessments for a standard 10,000 sq ft residential lot (all three services) can exceed $32,000–$35,000 upfront, with 30-year installment options adding interest (e.g., ~$1,200–$1,500 annually). Prepayment periods avoid financing costs. Total soft costs for North 1 alone exceed $227.5 million, including utilities, fiber optics, and storm drains.
Delays have occurred due to funding pauses, bidding, and resident pushback, but acceleration is underway. Below are details on key phases as of December 5, 2025.
Key UEP Phases
| Phase | Location & Coverage | Status & Timeline | Estimated Costs & Assessments | Key Updates |
|---|---|---|---|---|
| North 1 West | Northeast quadrant: West of Del Prado Blvd, east of Santa Barbara Blvd, along Kismet Parkway E, north of NE 9th St. Covers ~6 contract areas; serves thousands of parcels transitioning from wells/septics. Includes stormwater and road upgrades. | Under active construction (started ~2023). Expected completion: 2026 (utilities online late 2025 in some contracts). Contract 10 bidding opens soon; weekly “Construction Look Ahead” updates available. Residents notified via mail/hand-delivery for disruptions (e.g., driveway closures). | Total phase: Part of $227.5M North 1 budget. Per standard lot: $32,000+ assessment (prepay periods ended July 2024; now on 30-year installments starting Nov 2024). Includes capital charges for expansions. | Staging and preparations visible; focus on safety and restoration (streets/sod/driveways repaired post-construction). Funded via assessments; environmental benefits emphasized. |
| North 1 East | Northeast quadrant: East of Del Prado Blvd, west of US 41, south of NE 28th St, north of NE 10th Terrace. Covers ~5 contract areas; ~8,400 parcels over 4.3 sq miles. | Bidding/design phase; initial assessment resolution approved Oct 2025. Construction start: 2026; completion: 2027. $6.5M state grant awarded Dec 2025 for reclaimed water. Contract 11 TBD. | Total phase: ~$227.5M (shared with West). Per standard lot: >$32,000 (notice to owners issued Oct 2025). Annual installments ~$1,200+ with interest. | Council nod on assessments highlights “paying the price” for past UEP pauses; eliminates septic risks and boosts property values. Public hearings ongoing. |
| North 6 | Far north, expanded restricted area (exact bounds TBD; likely northwest extension). Covers additional unserved zones for water/sewer/irrigation. | Fast-tracked planning; construction start: ~2028; completion: 2030. Part of sequenced northward push post-North 1. | Projected: $35,000+ per lot (higher than North 2’s $20,000 due to inflation/delays). Total phase costs not finalized; assessments via resolution. | Prioritized for aquifer relief; includes stormwater/roads. No active construction yet; tied to overall $1.7B+ UEP gap. |
| North 3 | North-central areas (post-North 1; specifics east/west of prior phases). Focus on mid-northern unserved parcels. | Planning/design; projected start: 2027–2028; completion: 2028. | ~$35,000 per lot; funding via assessments/fees. | Lower priority but sequenced for balanced growth; environmental mapping ongoing. |
| North 5 | Northern expansion (likely west/northwest; details emerging). | Early planning; projected completion: 2032. | Similar to North 3 (~$35,000+ per lot). | Long-term phase; supports projected population to 250,000 by 2030. |
| Hudson Creek | Northwest corridor along Hudson Creek; unserved residential/agricultural zones. | Construction: 2026–2027. | Assessments TBD (~$32,000–$35,000 range). | Includes creek-adjacent stormwater; tied to Pine Island improvements. |
| Pine Island Corridor | Along Pine Island Rd (west side); commercial/residential mix. | Construction: 2026–2027. | Per lot/parcel: Aligned with North phases (~$32,000+). | Focus on economic growth; road upgrades integrated. |
Additional UEP Notes
Benefits & Next Steps: Improves water reliability, reduces contamination, and adds reuse tech. Check weekly updates at capecoral.gov/uep or ccuep.com (hotline: 833-CAPE-UEP). For property-specific info, use the UEP map or contact utilities@capecoral.gov. Progress accelerates with grants, but resident input via public hearings shapes timelines.
Prior Phases: North 2 (northeast pilot) completed ~2022–2023 after 2017 start; set precedent with $20,000 assessments but highlighted delays/costs.
Funding & Challenges: Special assessments per Ordinance 8-99 (1999); prepay windows closed for North 1 West, but options remain for future phases. Backlash over costs (e.g., “unplanned growth” blame) led to moratorium talks, but state law limits fee hikes, pushing bonds/partnerships. Total UEP: $1.7–2B over 20–25 years.
Detailed Cost Breakdown for UEP Assessments
The Utilities Extension Project (UEP) assessments in Cape Coral are special non-ad valorem charges levied on properties in designated project areas to fund the extension of potable water, wastewater (sewer), and reclaimed irrigation utilities. These assessments ensure that “growth pays for growth” by charging only benefiting properties. They consist of two main components:
- Line Extension Assessment (Land Area Method): Based on the parcel’s size, calculated in “Equivalent Parcels” (EP), where 1 EP = 10,000 square feet (sq. ft.). This covers the construction costs for distribution and collection lines (pipes, mains, etc.) in the area. Larger parcels pay multiples of the per-EP rate (e.g., a 20,000 sq. ft. lot = 2 EP).
- Capital Facility Expansion Charge (CFEC) (Equivalent Residential Unit or ERU Method): Based on expected system demand, fixed at 1 ERU per parcel for a standard single-family home with a 5/8-inch meter (common for residential lots). This funds upgrades to treatment plants, pump stations, and overall capacity to handle increased usage. Commercial or multi-unit properties may have higher ERUs.
Assessments are set via city resolutions (e.g., for North 1 West: Resolutions 35-23, 36-23, 37-23) and can be adjusted for unique parcels (e.g., hammerhead lots at cul-de-sacs or tax-exempt institutional properties). Costs vary by phase due to differences in construction scope, terrain, and timing. Below, I focus on North 1 West (the most active/recent phase as of December 2025, covering the northeast quadrant) with comparisons to other phases. All figures are for a standard 10,000 sq. ft. residential lot (1 EP, 1 ERU) receiving all three services.
Data reflects initial prepayment amounts (without financing costs) unless noted; financed totals include interest and collection fees. As of December 2025, prepayment windows for North 1 West closed in July 2024, so most properties are on installment plans. Rates and amounts can fluctuate slightly with market conditions (e.g., interest rates).
North 1 West: Detailed Breakdown
This phase (active construction, completion ~2026) has the highest costs due to its scale (~6 contract areas, extensive northeastern extensions). Total prepayment: $33,367 per standard lot. Financed total: $35,930 (includes ~7.7% added for temporary/permanent financing).
| Component | Type | Amount (Prepayment) | What It Covers | Annual Installment (First Year, 30-Year Term @ 6.50%) |
|---|---|---|---|---|
| Water Line Extension | EP (1 EP) | $7,246 | Construction of water distribution mains/pipes to the parcel. | $812 (principal + interest) |
| Water CFEC | ERU (1 ERU) | $1,106 | Expansion of water treatment plants, pumps, and storage for demand. | $131 |
| Sewer Line Extension | EP (1 EP) | $13,330 | Construction of wastewater collection lines, lift stations, and force mains. | $660 |
| Sewer CFEC | ERU (1 ERU) | $3,390 | Expansion of wastewater treatment capacity and conveyance systems. | $258 |
| Irrigation Line Extension | EP (1 EP) | $6,041 | Construction of reclaimed water distribution lines for irrigation. | $1,490 |
| Irrigation CFEC | ERU (1 ERU) | $2,254 | Expansion of reuse water treatment and distribution for non-potable use. | $383 |
| Total | – | $33,367 | Full utility extension + capacity upgrades. | $3,734 (total first-year; decreases slightly annually as principal pays down) |
- Financing Notes: Default 30-year amortization (billed annually on property tax bill starting November 2024). Options for 20- or 25-year terms (higher annual payments, lower total interest) via election form (deadline July 31, 2024—past for this phase). Interest: Up to 6.50% (fixed for term). No partial prepayments; full payoff possible anytime at adjusted amount. Hardship deferrals (10–100% of installment) available for low-income homesteaded properties (income guidelines ~$50K–$75K household; reapply yearly by April 15).
- Additional Fees: ~$200–$500 one-time connection/meter installation (billed separately by city utilities). Ongoing monthly utility rates apply post-connection (e.g., ~$20–$40 base for water/sewer).
Comparison Across Key Phases
Costs differ by phase due to project age, location (e.g., easier southern access vs. northern expansions), and inflation. Below are prepayment totals for standard lots in select phases (financed totals ~7–10% higher). North 1 phases are pricier due to recent bids and northern logistics.
| Phase/Project | Total Prepayment | Key Differences from North 1 West | Example Annual Installment (First Year) |
|---|---|---|---|
| North 1 West | $33,367 | Highest; extensive northeast lines, new stormwater integration. | $3,734 (30-yr @6.5%) |
| North 2 (Completed ~2023, northeast pilot) | $18,032 | Lower; smaller scale, earlier construction (pre-inflation). Breakdown: Water EP $3,021/CFEC $1,056; Sewer EP $2,154/CFEC $1,854; Irr EP $7,457/CFEC $2,490. | ~$2,000–$2,200 (20-yr @5%) |
| North 1 East (Bidding 2026, northeast extension) | ~$32,000–$33,000 (est.) | Similar to West but east of Del Prado; assessments approved Oct 2025, slight variance for ~8,400 parcels. | TBD (likely ~$3,500–$3,800, 30-yr) |
| Southwest 1 (Older southern phase) | $13,236 | Lowest; no sewer CFEC (phased in later); easier access. | ~$1,338 (20-yr @5.25%) |
| Southeast 1 | $23,310 | Mid-range; includes full CFECs, barrier island challenges. | ~$1,970 (20-yr @5.2%) |
| Pine Island (Western corridor) | $10,296 | Lowest overall; partial services (no sewer CFEC). | ~$1,100 (20-yr @5.25%) |
- Projections for Future Phases (e.g., North 3/5/6, Hudson Creek): Expected $35,000+ per lot due to inflation/delays (up ~5–10% from North 1). Fast-tracked North 6 (~2030) may see higher rates if bonds are used.
Payment and Billing Overview
- Billing: Non-ad valorem on annual tax bill (due November; ~2% discount if paid early). Includes principal, interest, collection costs (~1–2%), and discount recovery.
- Prepayment Savings: Avoids ~$2,500–$3,000 in interest (e.g., North 1 West: prepay $33,367 vs. financed $35,930 + interest over 30 years currently totaling ~$50,000+, projected to be ~$100,000+).
- Exemptions/Adjustments: Tax-exempt properties (e.g., churches) pay reduced ERUs. Undeveloped lots assessed but payable upon development/occupancy.
- Total UEP Impact: Across all phases, assessments fund ~$1.7–2B over 20–25 years. For property-specific quotes, use the city’s UEP map or contact utilities@capecoral.gov / (239) 574-UEP.
For the latest (post-December 2025 updates), check capecoral.gov/uep or ccuep.com, as bids and rates evolve.
